Cost Realism Analysis Software for Federal Proposals Cost realism is one of GAO's most frequently cited grounds in the "unreasonable cost or price evaluation" protest category — a bucket that, along with unreasonable technical evaluation, drove the bulk of GAO's 53 sustained protests in FY2025 alone, out of 380 merit decisions reviewed that year (GAO's FY2025 Bid Protest Annual Report).

If your team submits cost-reimbursement proposals, understanding how agencies evaluate realism isn't optional. Many pricing teams still build cost volumes in disconnected spreadsheets, which makes it painfully easy to submit labor rates that don't hold up, miscalculate an adjustment, or lose track of the documentation an evaluator — or a GAO attorney — will eventually ask for.

This guide breaks down what cost realism analysis actually requires, how it differs from price realism and reasonableness, where contractors most often get tripped up, and how purpose-built software helps pricing teams build defensible, audit-ready proposals without adding headcount.

Key Takeaways

  • Cost realism under FAR 15.404-1(d) applies only to cost-reimbursement contracts
  • Teams often confuse it with price realism and price reasonableness—each has different rules and outcomes
  • GAO sustains protests when documentation is missing or adjustments go unexplained
  • Purpose-built pricing software can cut time to final pricing by 90%+ with a full audit trail

What Is Cost Realism Analysis?

FAR 15.404-1(d)(1) defines cost realism analysis as the process of "independently reviewing and evaluating specific elements of each offeror's proposed cost estimate to determine whether the estimated proposed cost elements are realistic for the work to be performed" and consistent with the offeror's technical approach (FAR 15.404-1).

In cost-reimbursement contracts, the government pays actual allowable costs, not the proposed number. A bid that looks strong on paper means little if it cannot hold up in performance. Agencies therefore scrutinize:

  • Direct labor: hours, mix, and rates by category
  • Overhead and G&A: indirect rate application and consistency
  • Materials: quantities, sourcing, and pricing basis
  • Subcontracting: flow-down realism and alignment with the prime's technical approach

Probable Cost, Not Proposed Cost

Under FAR 15.404-1(d)(2), the analysis produces a probable cost — the government's best estimate of what performance will actually cost — which agencies must use for best-value comparison, even though award is still made at the offeror's proposed cost. Probable cost can be adjusted upward or downward from what you submitted.

Cost realism applies to cost-reimbursement contracts. It generally does not apply to firm-fixed-price, time-and-materials, or labor-hour contracts, though a related price realism review can apply to fixed-price competitions when the solicitation calls for it.

GAO's decision in Prism Maritime, LLC (B-409267.2, B-409267.3) shows the risk. The Navy essentially checked minimum Service Contract Act wages instead of testing whether the offeror's labor rates could attract and retain the proposed junior, mid-level, and senior mix. It also used proposed costs rather than evaluated costs in the source selection decision (GAO decision). A legally compliant wage rate is not automatically a realistic one.

Cost Realism vs. Price Realism vs. Price Reasonableness

These three terms get mixed up constantly, and that confusion leads to contractor protests. Here's the distinction: reasonableness asks if a price is too high; realism (cost or price) asks if it's too low.

Concept Applies to Required? Adjusts cost/price? How it's used
Cost realism Cost-reimbursement contracts Mandatory under FAR 15.404-1(d)(2) Yes — produces probable cost Used for best-value comparison
Price reasonableness All contract types Standard practice under FAR 15.404-1(b) No — informs judgment only Confirms price isn't excessive
Price realism Competitive fixed-price contracts Only if the solicitation says so No, generally Assesses performance risk from a low price

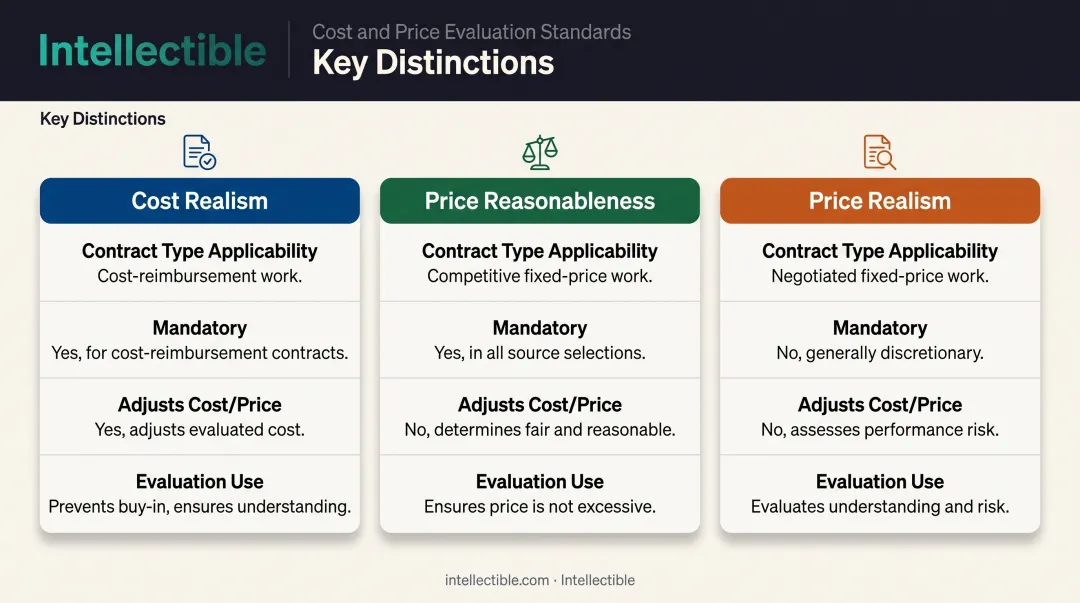

Cost realism versus price realism versus price reasonableness comparison chart

In Inbound, LLC (B-419853.5), GAO reaffirmed that absent an express solicitation provision, an agency is neither required nor permitted to run a price realism analysis on a fixed-price procurement (GAO decision).

If your solicitation is fixed-price and silent on realism, don't build a cost volume as if it were cost-reimbursement. You'll waste effort defending against evaluation criteria that don't exist.

Why Cost Realism Trips Up Contractors

Manual, spreadsheet-based cost proposal development is where most of the risk hides. When labor rate justifications live in one tab, the technical narrative lives in a Word document, and subcontractor quotes sit in someone's inbox, nothing stays connected. Disconnected numbers are exactly what GAO looks for.

These patterns show up repeatedly in protest decisions:

  • Mechanical adjustments — In The Jonathan Corporation; Metro Machine Corporation (B-251698.3, B-251698.4), GAO sustained a protest after the Navy adjusted hours and material costs toward its own estimate instead of the offeror's approach (GAO decision).
  • Calculation and scope errors — In Solution One Industries, an evaluator applied an incorrect rate and skipped an adjustment in one contract year (protest denied for lack of competitive prejudice).
  • Unexplained rate deviations — In ABSG Consulting, GAO upheld a $418,000 upward adjustment when a lower subcontractor overhead rate went unexplained.
  • Documentation that holds upNHIC Corporation survived protest because the file included worksheets, DCAA consultation, and a clear tie between labor mix and technical approach.

The compounding problem: teams juggling multiple CLINs, subcontractor inputs, and audit trail requirements under a two-week RFP turnaround rarely have time to verify every cross-reference by hand. Broken links between rates, hours, and technical approach are what surface in evaluation.

Four recurring cost realism protest patterns from GAO decisions

How Cost Realism Analysis Software Streamlines the Process

Purpose-built AI workflow platforms tackle this by keeping cost elements, technical narrative, and pricing logic in one connected system instead of scattered across files.

Intellectible's Pricing Engine, for example, replaces spreadsheet sprawl with a centralized costing workspace. Its documented workflow runs through five stages:

  1. Intake — capture scope, volume, location, and source documents like RFPs and CRM notes
  2. Extract — AI parses documents and surfaces pricing data with source evidence and confidence signals (one documented example shows 92% extraction confidence)
  3. Review Assumptions — validate wage rates, benchmarks, and cost drivers before they go further
  4. Build Cost Model — configure labor, rates, geography, and margins, then compare scenarios
  5. Publish Pricing — generate customer-ready pricing while routing internal numbers through finance approvals

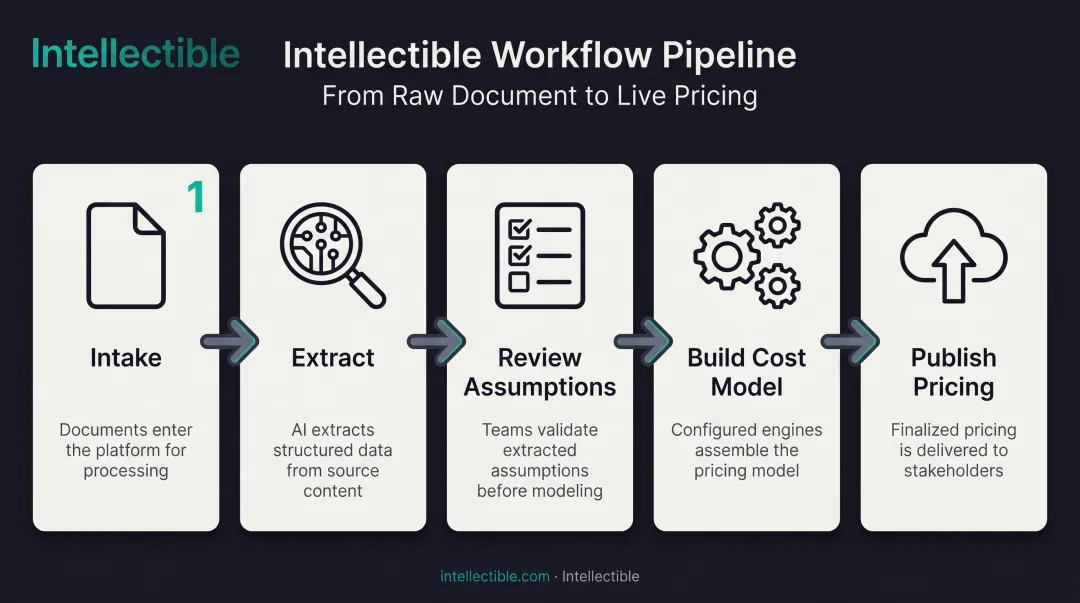

Five-stage pricing engine workflow from intake to published pricing

Because the Proposal & Pursuit Engine and Pricing Engine run on the same platform, technical requirements and their cost implications stay linked throughout drafting. Narrative and pricing teams no longer work from separate files that drift apart by submission day.

When a cost realism evaluation is challenged after award, that history matters. The platform keeps a full audit trail:

  • Visible activity log of what changed and who changed it
  • Version tracking with preparer and status indicators
  • Traceable approval path across departments

Intellectible reports a 90%+ reduction in time to final pricing for clients including Oceus and HHS, without adding headcount to the pricing team. Rather than rebuilding cost infrastructure for every new RFP, teams reuse the same connected engines for opportunity qualification, technical drafting, and pricing. That reuse lets a lean team scale proposal volume instead of working longer hours.

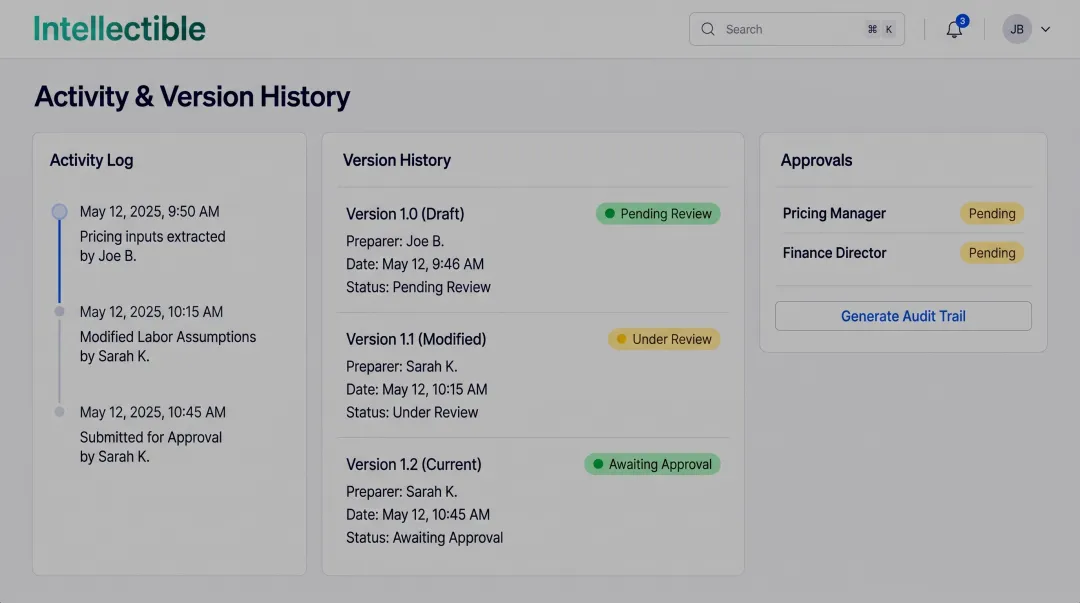

Pricing platform dashboard showing audit trail and version tracking history

Best Practices for Passing Cost Realism Scrutiny

A few habits separate proposals that survive evaluation from ones that get flagged:

  • Read the solicitation first. Identify exactly which CLINs trigger cost realism review and what substantiating data the RFP demands. Don't assume every element gets the same scrutiny.
  • Tie every cost element to the technical approach. Labor mix, basis of estimate, and escalation rates should all trace back to specific work packages, not sit as standalone numbers.
  • Mark proprietary data correctly. FAR 52.215-1(e) requires specific legend language on the title page and each restricted sheet. Skip it and you risk disclosure—and confusion about what is protected during evaluation.
  • Document every adjustment. If your rate deviates from a government estimate or historical benchmark, write down why — the ABSG case shows that an explained deviation survives; an unexplained one gets adjusted against you.

Frequently Asked Questions

Which estimating method holds up under a cost realism evaluation?

Bottom-up estimating traceable to the work breakdown is what evaluators can actually test, often paired with three-point ranges to show risk awareness. Analogous and parametric estimates alone rarely survive realism review on a large procurement, because there is no line-level basis to probe.

Can you explain cost analysis in a simple way?

Cost analysis reviews individual cost elements — labor, materials, overhead — to judge whether a proposed price is fair, realistic, and reasonable. It's the government's way of checking your math against your story.

How does an evaluator use cost realism to eliminate a bid?

By testing whether your proposed cost can deliver the proposed technical approach. Where staffing levels, labor mix, or escalation look too low to perform the work, the evaluator can adjust your probable cost upward or find the approach not credible — which removes the bid regardless of the price submitted.

What is the difference between cost realism and cost reasonableness?

Cost realism checks whether costs are too low for the proposed technical approach; reasonableness checks whether costs are too high given market conditions. They test opposite risks.

Does cost realism analysis apply to fixed-price contracts?

No, cost realism is reserved for cost-reimbursement contracts under FAR 15.404-1(d). A separate price realism analysis can apply to competitive fixed-price contracts, but only if the solicitation explicitly requires it.
