Labor represents the largest, most audited cost element in most government proposals. A single miscalculated wrap rate or an outdated overhead figure can mean an underpriced contract or a lost award. Pricing defensibility is now the top reason proposals get rejected, ahead of technical deficiencies, according to Deltek's 2026 GovCon Clarity study of more than 900 contractors.
This article breaks down what labor cost estimating software actually does, the features that matter, the estimating methods contractors rely on, and how AI-powered platforms like Intellectible are changing the pricing workflow entirely.
Key Takeaways
- Labor cost estimating software reduces pricing errors and builds defensible audit trails automatically
- Accurate wrap rates (fringe, overhead, G&A) protect bid competitiveness and prevent underpricing
- AI-driven platforms cut time-to-final-pricing by automating rates, labor mapping, and compliance docs
- FAR 31.201-2 and FAR 31.203 require traceable, benefit-based indirect cost allocation
What Is Labor Cost Estimating Software and Why It Matters
Labor cost estimating software builds competitive, audit-defensible rates from direct labor, fringe, overhead, G&A, and profit. It replaces the spreadsheet-and-formula approach most contractors still lean on.
That reliance on spreadsheets creates real risk. Version control breaks down across teams, formulas get copied incorrectly, and nobody can trace where a number originated six months later when a contracting officer asks.
FAR 31.201-3 sets a high bar: a cost is reasonable only if its nature and amount reflect what a prudent business person would incur, and there's no automatic presumption that a contractor's costs qualify. FAR 31.201-4 requires that indirect costs be allocated based on relative benefits received, not convenience.
That means every labor rate in your proposal has to tie back to:
- Your technical solution and staffing plan
- Historical performance data from comparable work
- A documented, traceable calculation path
Without that traceability, a contracting officer's forward-pricing review (the kind DCAA routinely performs on proposed base labor rates) can stall or sink your proposal.
Core Features to Look For
The right platform should handle four things well:
- Wrap rate automation — real-time recalculation as fringe, overhead, and G&A pools change
- Labor category benchmarking — comparing your rates against GSA ceiling data and historical awards
- Basis of Estimate (BOE) documentation — audit-ready justification for every assumption
- System integration — consistent data flow between pricing, proposal, and CRM tools
Wrap rate automation only works if the underlying pools are sound. FAR 31.203 doesn't prescribe one universal wrap-rate formula. It requires logical indirect cost pools and allocation bases tied to actual benefit received. A generic multiplier that ignores your specific pools and bases can create compliance exposure, not just pricing errors.

Intellectible's Pricing Engine models labor, rates, service levels, geography, materials, and risk within a single costing workspace. One documented facility-services scenario shows a $5.7 million contract with labor at 82% of total costs ($4,451,429), built with a transparent margin bridge rather than a black-box percentage.

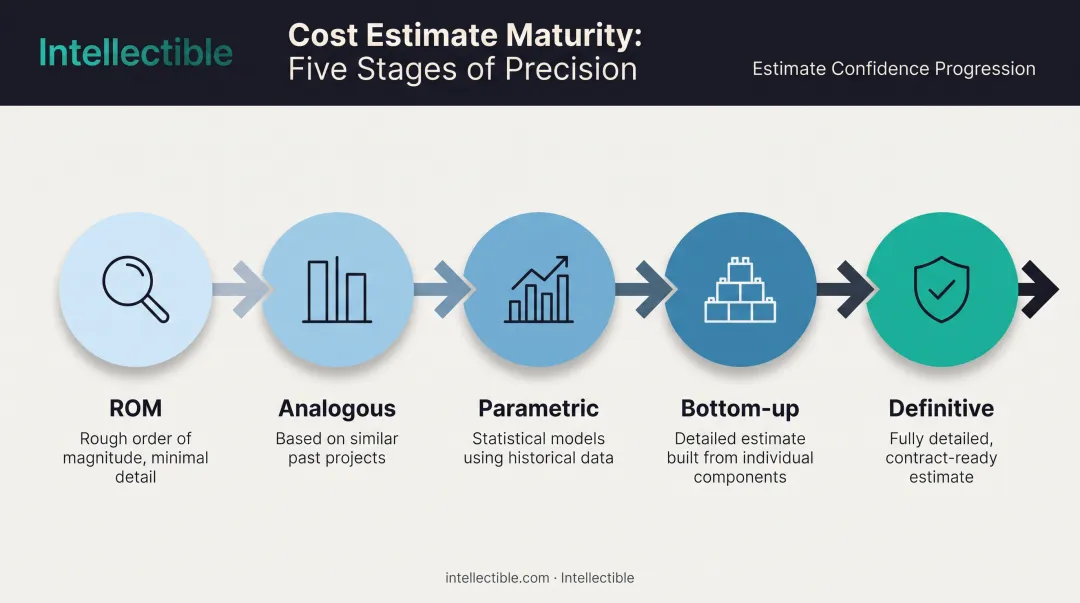

The 5 Levels of Cost Estimation Explained
Contractors move through progressively detailed estimate levels as a capture opportunity matures. Understanding where you sit in that progression tells you how much rigor your labor numbers need.
| Level | What It Is | When You Use It |
|---|---|---|
| ROM | Rough order of magnitude, low precision | Early feasibility, bid/no-bid screening |
| Analogous | Based on a comparable past program, adjusted for differences | When comparable actuals exist but scope isn't decomposed yet |
| Parametric | Statistical model using cost-driving variables | Standardized tasks with validated historical drivers |
| Bottom-up | Detailed, itemized buildup at the labor-category level | High-precision proposals, complex or high-risk work |
| Definitive | Fully validated, audit-ready final estimate | Proposal submission |
The GAO Cost Estimating and Assessment Guide frames analogous, parametric, and bottom-up as distinct methods, while ROM and definitive describe estimate maturity rather than separate techniques. As your capture matures, your estimate should naturally progress from analogy or parametrics toward a fully itemized, defensible buildup.

Common Labor Cost Estimating Methods for Government Contracts
The right method depends on your historical data depth and how mature the requirement is.
- Analogous estimating: Fast and based on similar past projects, but less precise. Best for early planning.
- Parametric estimating: Statistical models applied to standardized labor tasks backed by reliable history.
- Bottom-up estimating: Builds cost task by task for maximum accuracy. Best for complex or high-risk work.
Contract type should drive the choice as well. FFP contracts put maximum cost risk on you, the contractor. FAR is explicit that fixed-price terms will not be adjusted for your actual cost experience, so elevated risk calls for conservative buffers and detailed bottom-up work.
Cost-plus-fixed-fee contracts, by contrast, place less cost risk on the contractor and offer little incentive to control spend. Detailed breakdowns still matter, mainly for evaluator scrutiny rather than your own risk management.
Step-by-Step Process for Building an Accurate Labor Cost Estimate
Here's the sequence that produces a defensible number every time:
- Define scope and labor categories — Map every role the contract requires, then pull historical rates and current market data so your baseline reflects real labor costs.
- Select your estimation method — Choose bottom-up, analogy, or parametric estimating, and separate direct labor from indirect cost pools before you build any rates.
- Calculate wrap rates — Layer fringe, overhead, and G&A onto base labor rates using your approved pool structure so fully burdened costs stay consistent with DCAA expectations.
- Document your Basis of Estimate — Record sources, assumptions, and reliability notes for every figure so auditors can trace each cost element to its origin.
- Run sensitivity analysis — Stress-test labor rates, hours, and escalation assumptions before you lock the final price.
GAO guidance expects documentation that shows the source, reliability, and methodology behind every cost element, traceable back to its origin.

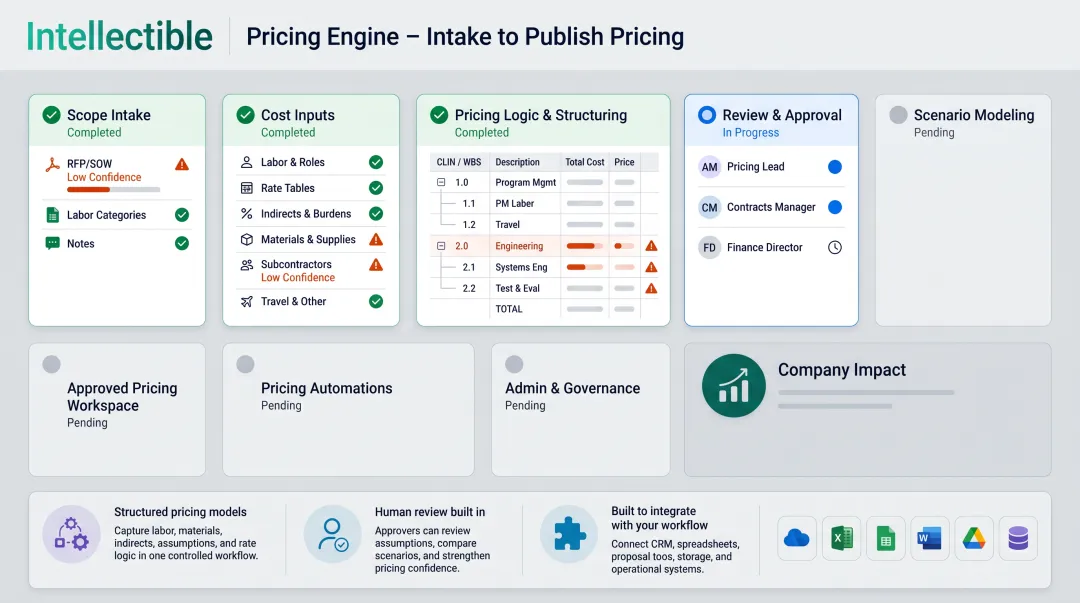

Software can enforce this sequence instead of leaving it to spreadsheets. Intellectible's Pricing Engine runs Intake → Extract → Review Assumptions → Build Cost Model → Publish Pricing, flagging missing fields and low-confidence data points before they reach your final submission.

Common Challenges and How AI-Powered Platforms Solve Them
Three problems show up again and again in labor pricing:
- Outdated overhead and wrap rates. Rates calculated last fiscal year rarely reflect current fringe or G&A pools, quietly eroding your margin on award.
- Spreadsheet chaos. Multiple versions circulating across proposal, pricing, and capture teams create mismatched labor category data and no single source of truth.
- Missing audit trails. When a contracting officer asks how you arrived at a rate, "the spreadsheet says so" isn't an answer that survives review.
Intellectible's Pricing Engine addresses these by centralizing pricing inputs and connecting them to a governed workflow. It extracts labor and cost assumptions directly from RFPs, surveys, and attachments, retaining source evidence and confidence signals for every value rather than a static number pasted into a cell.

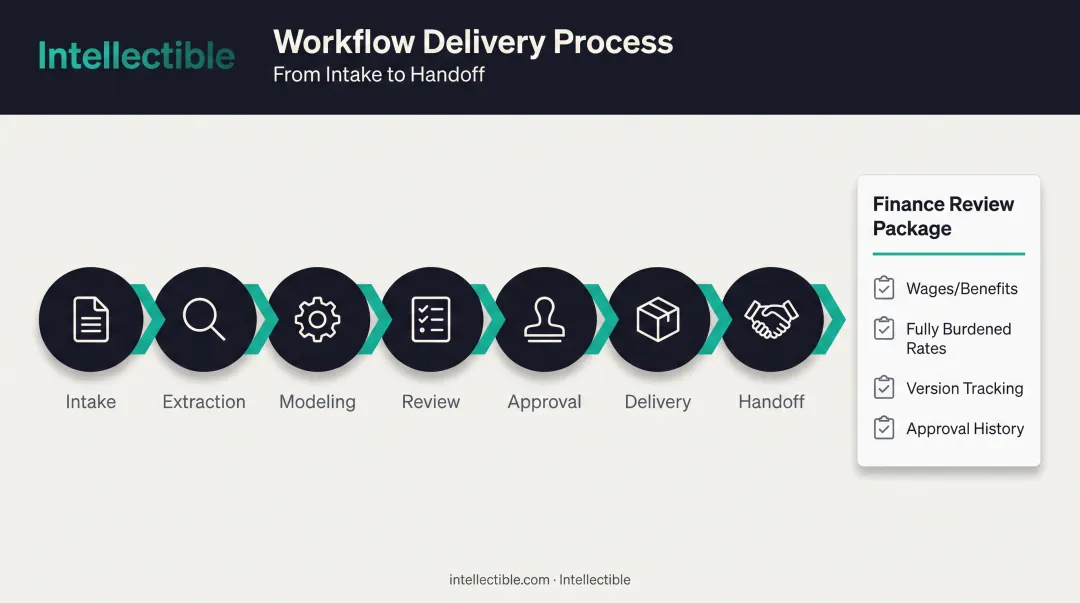

The workflow runs through Intake → Extraction → Modeling → Review → Approval → Delivery → Handoff. A Finance Review Package captures:

- Wages and benefits
- Fully burdened rates
- Version tracking and effective dates
- Full approval history
That's the traceable record a review process actually needs.
Intellectible customer results show a 90% reduction in time to final pricing with full audit-trail control, without adding headcount to the pricing team.
Frequently Asked Questions
How do labor estimates tighten as a pursuit matures?
Early ROM figures give way to analogous and parametric estimates, then to a bottom-up build as the staffing plan firms up and finally to a definitive, audit-ready basis. For labor-driven services work the pivot point is the staffing plan: until skill mix and hours per position are settled, the labor line cannot be defended at any level.
What is the difference between cost analysis and price analysis?
Price analysis compares your total proposed price against market benchmarks or historical prices, without examining individual cost elements. Cost analysis digs into each component, labor, overhead, and fee, to test whether the underlying costs are reasonable.
How do you calculate a fully burdened labor rate?
You layer fringe, overhead, and G&A onto a base labor rate according to your approved indirect cost pools and bases. FAR 31.203 requires logical grouping and benefit-based allocation, not a generic universal multiplier.
Why is labor cost estimating software important for DCAA compliance?
It creates consistent, auditable documentation of every cost calculation and assumption, showing sources, confidence levels, and approval history. That traceability is exactly what forward-pricing reviews look for.
Can small government contractors benefit from cost estimating software?
Yes. Automation lets lean teams model labor costs, compare scenarios, and generate audit-ready pricing without adding pricing analysts. With Intellectible, teams can scale that pricing process without adding headcount.
