Introduction
A company breaking ground on a new plant or distribution center doesn't send out a press release the day the permit gets stamped. By the time the news hits trade publications, competitors have already made contact.
Building permit records surface these projects earlier, often months before construction becomes public knowledge. For a sales leader at an equipment, construction, or site-services company, that is the difference between arriving during specification and arriving after the vendor is chosen, repeated across every account in the territory.
The challenge is scale. The Census Bureau's permit data tracked roughly 19,900 permit-issuing places as of January 2023, and each one uses its own portal, terminology, and record format. A single permit might list five different parties without ever stating who is actually building or occupying the facility.
One county is a portal and an afternoon. Every jurisdiction a team sells into is a coverage problem, and the gaps are invisible until a competitor is already on site. This article shows how to find, filter, verify, and act on permit records across U.S. jurisdictions, treating every record as a lead signal that still needs confirmation before it reaches a rep.
Key Takeaways
- Isolate facility-related permits using project type, status, valuation, dates, and location fields
- Separate the owner, developer, applicant, contractor, and architect before naming the opportunity
- Verify permit entities against websites, registries, planning filings, and news before outreach
- Build a repeatable monitoring workflow instead of running one-off manual searches
- Treat permitting delays, exemptions, and vague descriptions as real limitations, not edge cases
When Should You Use Building Permit Data and What Do You Need?
Permit research earns its keep in specific situations. It's useful for:
- Spotting construction activity before it shows up in news or industry reports
- Prioritizing accounts based on confirmed project activity rather than guesswork
- Tracking facility expansion for existing customers or target accounts
- Identifying contractors active in a region or facility type
- Monitoring development trends across a geography or industry
Permit data isn't conclusive on its own. Treat a record as inconclusive when it:
- Has missing fields or falls under an exemption
- Carries an outdated status or covers only one phase of a larger project
- Uses a description too vague to confirm a facility build is underway
A permit for "interior alterations" could mean a new tenant buildout or a minor repair job.
What You'll Need Before You Start
Four prerequisites make the difference between useful research and wasted hours:
- A target facility profile: new construction, expansion, tenant improvement, manufacturing, healthcare, warehouse, office, or another commercial category you actually want to find
- Selected jurisdictions and their official sources: the specific permit, planning, zoning, inspection, assessor, or open-data portals for each market
- A research schema: a standard template capturing permit number, address, applicant, owner, contractor, description, type, status, issue date, valuation, estimated size, and source URL
- A verification and outreach process: a defined step where someone confirms a record before it lands in a CRM or gets assigned to a rep
Skip any of these and you'll end up with a spreadsheet full of half-identified leads nobody trusts enough to act on.
How to Use Building Permit Data to Find Facility-Building Companies
Reliable permit research follows a sequence: scope the search, locate records, filter for relevant projects, identify the companies involved, verify the findings, then monitor for changes. Skipping steps is how teams end up chasing dead leads.
Setup and Preparation
Before touching a single portal, define your geography, facility categories, date range, and permit statuses. Build a keyword list that covers how jurisdictions actually describe projects: new construction, shell, tenant improvement, expansion, warehouse, plant, distribution center, clinic, campus, commercial building.
For each jurisdiction, document:
- The most authoritative source (not a third-party aggregator)
- Update frequency and search limitations
- Downloadable fields and export formats
- Any registration or usage requirements
Austin's Issued Construction Permits dataset, for example, supports OData exports but explicitly warns that live reports can differ from its official Development Services records because the underlying database changes continuously. That kind of caveat matters when you're deciding how often to re-pull data.
Set up a deduplication process early. Large projects often generate multiple permits across phases, addresses, or work types, and treating each one as a separate lead inflates your pipeline with duplicates.
Searching and Filtering Records
Start broad: filter for commercial or industrial permits within your date range. Then narrow using project description, valuation range, construction type, occupancy classification, square footage, zoning, and status.
Don't rely on keywords alone. A project description might say "building improvements" while the occupancy field reveals it's actually a manufacturing facility. Structured filters catch what keyword searches miss, and vice versa.
Here's a worked example. Say you're searching a mid-size Texas county for new industrial construction over the past 90 days:

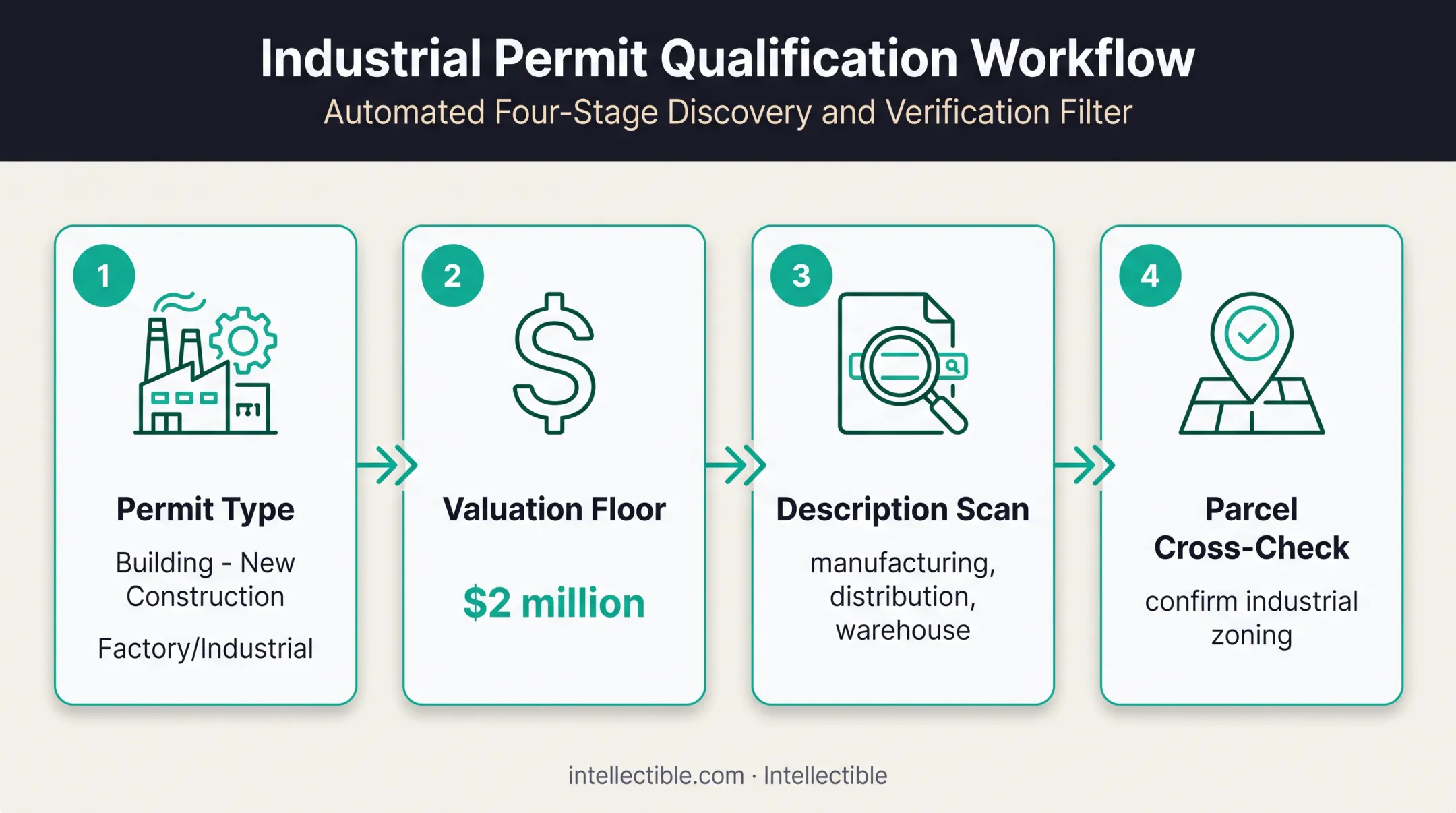

- Filter for permit type "Building - New Construction" with occupancy classified as "Factory/Industrial"
- Set a valuation floor of $2 million to exclude small shop buildouts
- Scan descriptions for terms like "manufacturing," "distribution," or "warehouse"
- Cross-reference addresses against parcel records to confirm zoning supports industrial use

That process can take a list of 200 raw permits down to a dozen plausible facility projects worth individual review. The remaining work is confirming who's actually behind each one.
Identifying the Relevant Companies
A permit record can name a property owner, applicant, developer, general contractor, architect, tenant, and subcontractors, often on the same form. Each role points to a different kind of outreach.
| Role | What they typically control | Best outreach fit |
|---|---|---|
| Property owner / developer | Project scope and budget | Site services, leasing, large equipment |
| Permit applicant | Submission, sometimes just paperwork | Verify before acting (often an agent) |
| General contractor | Construction execution | Subcontracting, materials, site equipment |
| Architect / engineer of record | Design documentation | Early-stage design-phase vendors |
| Tenant | Future occupancy and operations | Facility operations, long-term services |
Frisco, Texas's commercial permit ledger shows how this plays out in practice. One record lists permit B25-04043, issued for new building construction, with owner listed as HEB Grocery Company LP and general contractor EMJ Corporation. That single entry tells you exactly who to approach for a grocery-retail equipment pitch versus a subcontracting opportunity, based on Frisco's commercial permit report.
Flag records for manual review when the listed entity is an LLC, a holding company, a construction manager, or a design firm rather than an operating business. A property named "Parcel 14 Holdings LLC" tells you almost nothing until you trace it back to an actual operator through assessor records or business registries.
Monitoring and Updating
A permit issued today isn't a finished project. Track status changes, inspections, revisions, additional phases, certificates of occupancy, and expiration or cancellation events to understand whether work is actually progressing.
Set a review cadence that matches the project type. A fast tenant improvement might need weekly checks; a multi-year industrial build might only need monthly review. Preserve the original record, the retrieval date, and every subsequent change for auditability. That history matters if a deal takes months to develop.
This is where manual searching breaks down fastest. Revenue Discovery, Intellectible's monitoring engine, treats permit filings as an always-on signal alongside standard account feeds, running checks on nightly, daily, or weekly cadences depending on how time-sensitive the project type is. Updates route through automated detection, but nothing reaches a sales team without a human review step first.
How to Interpret and Verify Permit Records
Not every field on a permit carries equal weight. Focus on the ones that help you judge whether a project is a real opportunity:
- Permit type, status, and issue date
- Project description, address, and estimated size
- Owner, applicant, and contractor
- Valuation and related permit numbers
Reading the Timeline Correctly
Permit status tells a story, but each stage means something different:
- Application submitted: signals intent, nothing more
- Permit issued: authorization granted, but construction may not have started
- Inspections logged: work is actively progressing
- Certificate of occupancy: may indicate readiness, but doesn't confirm the business has actually opened
None of these alone proves a facility is complete or operational. A shell building permit, for instance, is built without a known tenant and never receives a certificate of occupancy on its own. The eventual occupant needs a separate buildout permit entirely.
A Practical Verification Checklist
Before treating a permit as a confirmed lead, check it against at least one independent source:
- Confirm the company's legal name through a state business registry
- Match the industry and facility type against the company's own website
- Cross-reference the address against assessor or planning records
- Look for related permits covering other phases of the same project
- Search for project announcements or local news coverage
Common Data-Quality Problems
Permit data is messy by nature. Watch for:
- Abbreviations and misspellings in applicant or owner names
- Duplicate permits covering the same project under different numbers
- Missing contractor fields, especially on early-stage applications
- Inconsistent valuation methods between jurisdictions
- Parcel or address changes mid-project
- Records that bundle multiple construction phases into one entry
New York City's own permit dataset, for example, excludes DOB NOW filings and notes that most current permits are issued through a separate system. One dataset alone won't capture the full picture, according to NYC's permit dataset documentation.
Use a confidence scale rather than treating every record the same:
- Unverified: matched by address or keyword only
- Partially verified: entity confirmed, but role or timeline unclear
- Verified project participant: confirmed role, unconfirmed facility status
- Confirmed facility operator: independently verified company, project, and current status

How to Turn Permit Records Into Qualified Opportunities
A verified permit record only becomes useful once a team acts on it. Different functions use the same signal differently:
- Equipment and site services companies identify upcoming demand before competitors notice
- Contractors assess subcontracting or partnership opportunities on active projects
- Economic development teams track investment activity across a region
- Revenue teams prioritize accounts showing real, dated construction activity
Building a Qualification Framework
Score each permit-derived lead against:
- Project fit: does the facility type match what you sell?
- Company fit: is this the kind of account you want?
- Timing: is the project stage right for your outreach?
- Geography: can you actually serve this location?
- Likely need: does the permit description suggest a specific product or service gap?
- Decision-maker accessibility: can you reach someone who controls the budget?
- Permit confidence: where does this sit on your verification scale?
- Evidence of active progress: inspections, revisions, or phase permits confirming the project is live
Once a record clears qualification, enrich it with industry, headquarters and operating locations, relevant contacts, estimated project stage, facility type, and the specific need the permit implies.
Outreach should reference the signal carefully. Don't claim more than the record supports. A permit application isn't proof of an open facility. Offer a relevant next step instead of a generic pitch tied to the construction activity you've observed.
Intellectible's Revenue Discovery engine is built to close this gap. It treats "permits filed" as a custom qualification tell and scores accounts for fit and urgency using editable team priorities.

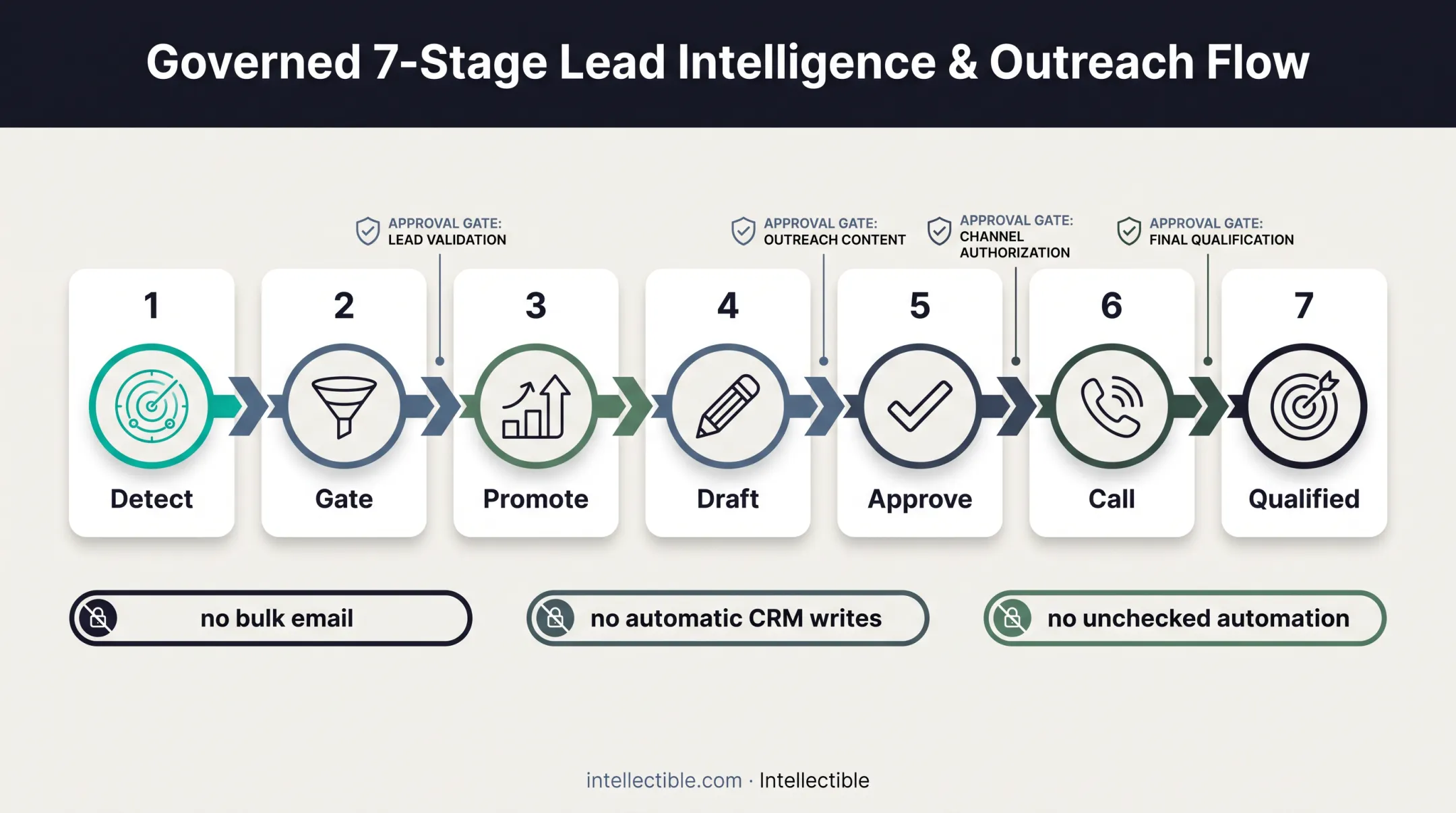

Records move through a Detect → Gate → Promote → Draft → Approve → Call → Qualified sequence. Every stage runs through four human approval gates: no bulk email, no automatic CRM writes, and no unchecked automation.

Project-scoped PostgreSQL databases hold the structured permit, company, and contact records so a team can query and reuse them instead of rebuilding research for every new account. Built-in contact finding then identifies who owns the buying decision at the company behind the permit, rather than leaving reps to guess from an applicant field.
Where Permit Research Fits in Practice
Permit research doesn't stand alone. It typically feeds into:
- Market selection
- Account discovery
- Lead qualification
- Territory planning
- Ongoing opportunity monitoring
- CRM enrichment
- Economic development reporting
How teams approach it depends heavily on scale:
| Approach | Coverage | Freshness | Review effort |
|---|---|---|---|
| Manual portal searches | Narrow, jurisdiction by jurisdiction | Depends on how often someone checks | High per lead |
| Spreadsheets | Limited by manual entry | Stale quickly | High, no automation |
| Data providers | Broad but generic | Varies by vendor | Low, but limited control |
| Direct APIs | Jurisdiction-specific, technical | Near real-time if maintained | Moderate, needs engineering |
| Automated workflow systems | Scalable across many sources | Configurable cadence | Low, with human checkpoints |
A local HVAC contractor might only need to monitor a handful of counties. A national revenue operations team chasing facility construction across dozens of states needs standardized collection and consistent entity matching. Otherwise, the same company shows up under three different name variants in three different systems.
Best Practices for Using Building Permit Data Effectively
A few habits separate teams that get real value from permit data versus those drowning in noise.
- Standardize fields first: field names, status definitions, facility categories, entity names, and retrieval dates need consistency before you compare records across jurisdictions
- Combine sources: pair permits with zoning cases, planning approvals, property records, procurement notices, business registrations, and occupancy records
- Keep humans in the loop: review ambiguous records, especially when a match could confuse a property owner with a tenant or an unrelated company with a similar name
- Match outreach to project stage: a newly filed application calls for education, not a hard pitch; an issued permit with active inspections might warrant direct qualification
- Track your own accuracy: review false positives, missed projects, source outages, and conversion outcomes regularly so the process actually improves
Conclusion
Finding companies building a facility requires combining the right filters, correctly interpreting who each party actually is, verifying that interpretation against independent sources, and timing outreach to match where the project really stands. A raw permit list alone is not a pipeline.
Treat permit data as an early, genuinely useful signal, not a confirmed fact. A documented, repeatable workflow turns scattered public records into market intelligence your team can actually trust and act on.
With roughly 19,900 permit-issuing places, the only version of this that holds together is a monitored one. Jurisdictions are re-queried on a cadence, new permits are matched to known companies and projects as they are issued, and the team reviews the records that changed rather than the whole file again. That is what keeps coverage even across a territory, instead of deep in the three counties somebody had time for.
Frequently Asked Questions
Are building permits public records?
Most U.S. building permit records are available through local government offices or online portals. Availability, specific fields, fees, and update timing vary significantly by jurisdiction, so always check the local source directly.
Do contractors have to pull permits?
Permit responsibility depends on jurisdiction, project type, and the arrangement between owner and contractor. The person listed as the permit holder isn't necessarily the facility's eventual owner or operator, so don't assume otherwise.
How can I use building permit data to find companies building a facility?
Select your target jurisdictions, filter for facility-related project types, and identify each party's role on the permit. Then verify that information against independent sources and monitor the project for status changes over time.
What information can you find in a building permit?
Common fields include address, permit type, project description, status, issue date, applicant, owner, contractor, and valuation. Exact coverage and field names vary by jurisdiction, so never assume one format applies everywhere.
How do you verify the company listed on a building permit?
Cross-check the name against official business registries, the company's own website, property or planning documents, related permits, and any project announcements or news coverage. Treat a single source as a starting point, not confirmation.
How current is building permit data?
Freshness depends entirely on the issuing authority and how often it updates its system. Always record your retrieval date and recheck status, inspections, and occupancy records before acting on older information.
