Introduction
Building permits can reveal expansion inside an existing customer account before the account manager hears about it. Match the site to the customer hierarchy, verify project status and contract scope, and combine the permit with locations, hiring, acquisitions, and relationship history to investigate additional service needs.
Amazon's Spokane Valley fulfillment center shows how this plays out. The Spokesman-Review reported grading and foundation applications and a building-permit approval before Amazon confirmed the project on February 18, 2021. That is one documented case, not a universal lead-time benchmark.
Finding expansion isn't as simple as searching for "expansion." Results depend on jurisdiction coverage, permit terminology, record freshness, entity matching, and how permits roll up into facility-level projects. This article walks through the process: define the profile, filter records, validate the signal, score it, and route it to sales.
Key Takeaways
- Permits can reveal expansion before an announcement or formal bid request.
- Search direct terms and proxy signals such as electrical upgrades and warehouse alterations.
- One permit rarely proves anything; combine scope, status, timing, owner, and contractor.
- Normalize names and addresses, and cluster duplicates into one facility record.
- Automation with human review makes monitoring repeatable.
How to Find Facility Expansion Using Building Permit Data
Step 1: Define the facility expansion profile
Run expansion research across the full customer base, not only new-logo prospects or accounts near renewal. New facilities, locations, acquisitions, hiring surges, and permits may change a customer’s need for your service before the account manager hears about it. Link those events to the customer hierarchy and current contract scope.
Then translate that target into observable permit signals:
- New construction and additions
- Square-footage changes and interior build-outs
- Production-line modifications
- Utility capacity increases
- Parking, site work, and environmental upgrades
- Multi-phase construction
Step 2: Find and filter relevant permit records
Sources differ by market. Seattle and Austin publish permit open data, while many counties and cities use portals such as Accela or Tyler EnerGov. Add planning and zoning systems, public works, environmental agencies, and utility filings.
Search by more than one phrase:
- Permit type and project description
- Owner, applicant, and contractor
- Facility address
- Issue date and status
- Direct and proxy keywords

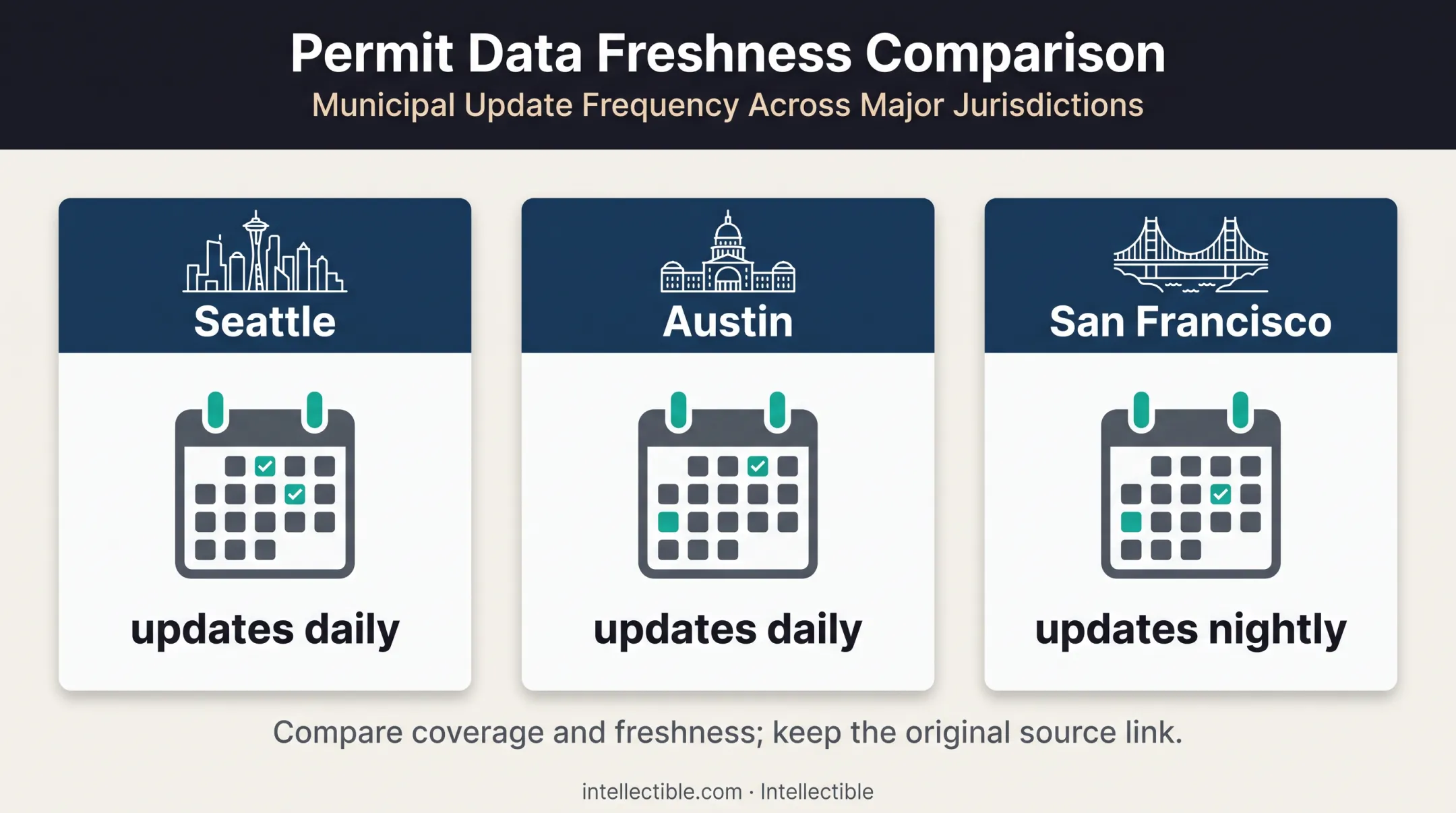

Fix a date range and geography. Then document each source's update frequency, missing fields, access limits, and terminology. Seattle's and Austin's datasets update daily, and San Francisco's updates nightly. A portal's search date may mean record creation rather than issuance, so confirm what that field represents.
Step 3: Group and validate permits at the facility level
Cluster records that share an address, parcel, owner, contractor, project name, or sequential phase. San Francisco repeats permit information across multiple-address rows, and Seattle allows phased submissions with separate scopes. Counting rows would inflate your lead list.
Next, check whether the work adds capacity. Exclude repairs, replacements, code corrections, and minor tenant improvements. Seattle's new-versus-alteration classification helps, but it doesn't prove added capacity on its own.
Then cross-reference the facility against its website, planning agendas, local news, environmental filings, and hiring announcements. In Rosemount, Minnesota, the Star Tribune reported planning approval for a Meta data center on December 1, 2023, months before the governor's March 2024 announcement.
Step 4: Score, enrich, and act on the opportunity
Build a practical score from:
- Project scope and permit status
- Recency and estimated value, when available
- Number of related permits
- Facility fit and decision-maker relevance
- Confidence in the company match
Enrich qualified records with:
- Facility operating name and address
- Owner or developer and general contractor
- Likely decision-makers and project stage
- Source links and a recommended next action
For repeatable processes, Intellectible can connect permit inputs, databases, scoring rules, human review, dashboards, and CRM actions into a custom workflow. It doesn't supply the permit data itself. Its Revenue Discovery engine lists permits filed as a business-defined signal, runs nightly, daily, or weekly, and uses four human approval gates.

When Should You Use Building Permit Data, and What Do You Need First?
Permit data works best for detecting public evidence of planned physical change early. It supports direct research and relationship building, but it does not replace them.
Typical use cases
- Identify prospective facility expansions
- Prioritize construction or equipment accounts
- Forecast regional demand
- Find contractors active in a target market
- Spot organizations needing design, materials, equipment, staffing, or facility services
Beyond live filings, historical records suit market sizing, territory planning, and expansion-pattern analysis.
Situations where it becomes risky
Coverage gaps, delayed records, vague descriptions, and unavailable filings produce false positives and misses. Projects stall after filing as well. Portland, for example, documents owner-requested cancellation, abandonment of inactive applications, and expiration after issuance.
A permit isn't proof of an approved purchase or a chosen vendor. Verify the project stage before outreach.
What you need first
Systems
- Access to permit sources
- Structured spreadsheet or database
- Address and entity normalization, duplicate detection, and source-link retention
- CRM or task system
Inputs
- Target facility profile and priority geographies
- Keyword and proxy lists
- Time window and a clear definition of a high-priority signal
Readiness
- A reviewer who knows construction terms and local permitting
- Documented checks on data governance, privacy, terms of service, and outreach rules
Compliance still applies. Socrata's API rules do not grant permission to scrape municipal portals, and the FTC's CAN-SPAM guidance has no B2B exception. Honor opt-outs within 10 business days.
Key Parameters That Affect Results When Using Building Permit Data
Translate the event into a whitespace hypothesis: which current service could extend to the new site, business unit, or acquired company? Compare the need with the contract’s geographic and service scope. Record both the verified change and the assumption that still needs customer confirmation.
Permit source coverage and freshness
Jurisdictions publish different fields, permit types, date ranges, and update schedules. A narrow source set creates geographic or industry blind spots. Compare coverage and freshness, and keep the original source link. Delayed records mean you contact a company after a competitor already has.

Search terms and proxy indicators
Explicit descriptions include expansion, addition, and new facility. Indirect signals include:
- Warehouse alterations
- Electrical service upgrades
- Process equipment
- Loading-dock changes
- Phased site development
Layer your keywords with synonyms, trade terms, permit categories, and known project patterns. Review every proxy match manually before calling it an expansion.
Permit status, issue date, and project phase
Status signals commercial readiness, and definitions vary by city. Portland examples:
- Approved to Issue: technical review is done and fees are billed
- Issued: paid with no inspections yet
- Under Inspection: work has started
NYC's job-status codes use different definitions again. Never assume statuses are universal.
Prioritize recent, active records and keep older ones for trend analysis.
Facility identity and geographic clustering
One organization may use several legal entities, addresses, parcels, and contractors. In the Amazon case, the landowner, the filer, and the operator were three different entities. To resolve identity:
- Standardize addresses (USPS Publication 28 sets the format)
- Match parcels
- Normalize names
- Review maps
Scope, scale, and supporting evidence
Descriptions, valuation, floor-area changes, and contractor identity separate meaningful expansion from routine alteration. Combine fields and outside signals into a confidence score. Valuation is typically applicant-estimated or missing, so don't read it as a project budget.
Common Mistakes and Troubleshooting When Using Building Permit Data
Common mistakes
- Searching only "facility expansion" and missing additions, fit-outs, utility improvements, and site work
- Treating every permit as its own project, or every construction record as a lead
- Ignoring source limits, local status definitions, and the chance an approved project is delayed or cancelled
- Contacting a company before confirming the facility, relevance, and decision-maker
Once the facility and decision-maker check out, keep outreach short and permission-conscious:
I saw the recent addition permit at your Dallas distribution site. We help facilities with racking and dock equipment. Would a short intro be useful? Reply "no" and I won't follow up.
Include a postal address and opt-out, per FTC rules.
Troubleshooting issues
When results look off, diagnose the pattern before you rebuild the whole search.
Too many irrelevant records
- Likely cause: broad terms, proxy matches treated as conclusive, residential or maintenance records left in.
- Adjust: narrow by facility type, permit category, scope, geography, status, and dates. Add negative terms and require human validation.
Duplicate or fragmented facility records
- Likely cause: address, entity, project-name, or parcel variations, plus phased permits.
- Adjust: standardize names and addresses, compare parcels and contractors, keep one canonical facility record, and link related permits to it.
Few useful opportunities despite active construction
- Likely cause: weak source coverage, delays, missed proxy terms, or a target that's too narrow.
- Adjust: audit coverage, widen keywords and permit types, add planning and utility records, compare against local news, and document gaps.
Alternatives to Using Building Permit Data

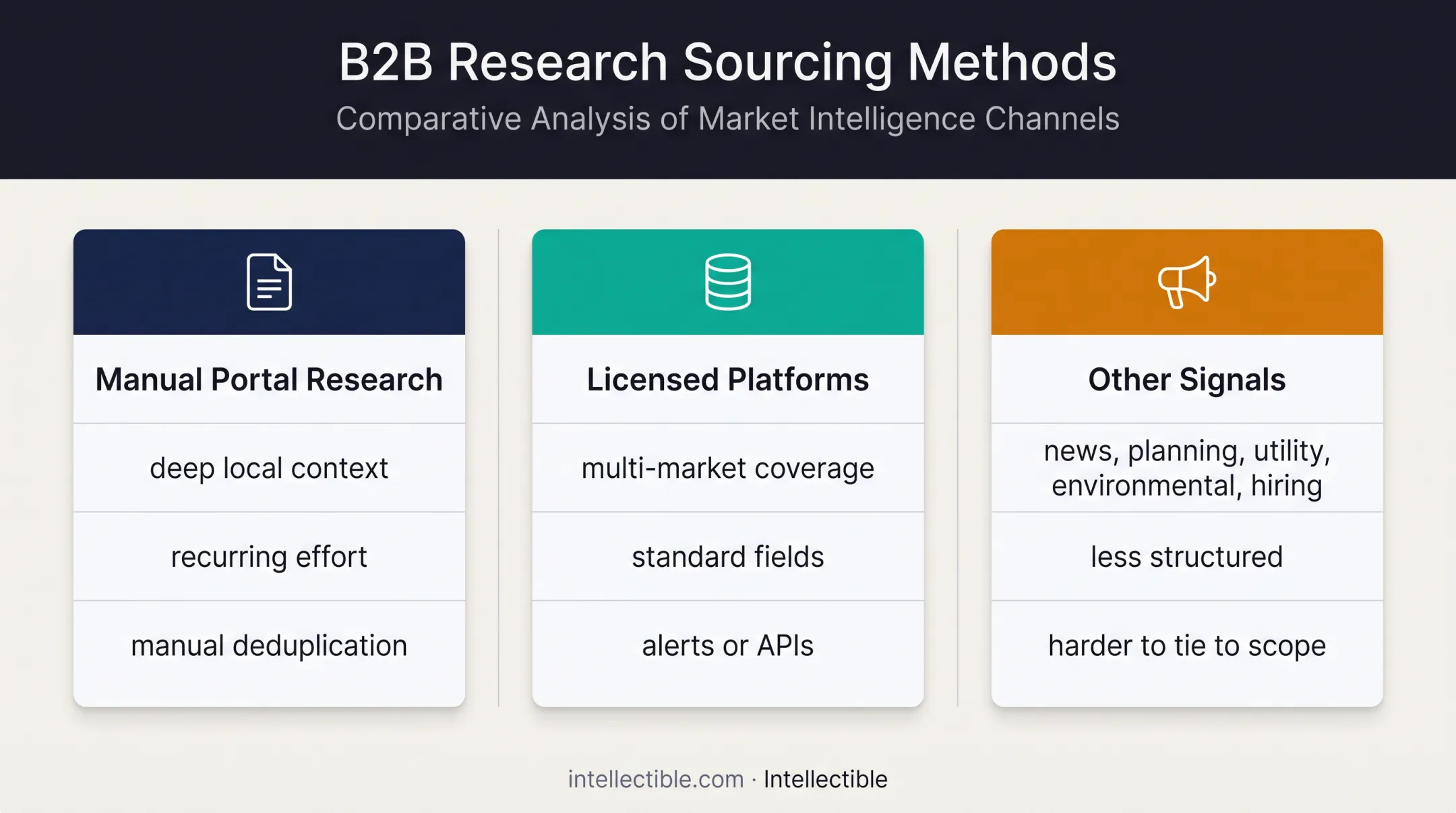

Permits capture public, physical, regulated change. Other methods fit better when a project is private, early-stage, outside local coverage, or not yet permitted.
Manual local portal and planning-record research
Use this when you need deep document review in a few priority jurisdictions. You get rich local context, but pay for it with recurring effort, inconsistent workflows, and manual deduplication.
Construction intelligence or licensed permit-data platforms
Choose a platform when multi-market coverage, standard fields, alerts, or APIs matter more than local depth. Construction Monitor claims thousands of jurisdictions, and ConstructConnect claims over 1M US and Canadian projects, though those figures use different units.
Before buying, check:
- Coverage and freshness of records
- Field depth for your use case
- Licensing terms and API access
News, planning, utility, environmental, and hiring signals
These signals surface early announcements, infrastructure activity, environmental approvals, or workforce growth before a building permit exists. They are less structured and harder to tie to a specific scope. Amazon projected 1,000 jobs, for example, but projections are not actual hiring.

Conclusion
Permit-based expansion prospecting works when the target profile, source coverage, search logic, and validation are deliberately defined.
- The strongest leads combine direct descriptions with proxy signals, clusters, status, timing, and corroboration.
- Most failures come from incomplete coverage, poor normalization, reliance on one keyword, and treating a permit as a guaranteed sale.
- A repeatable workflow turns public construction activity into a prioritized, auditable pipeline, balancing speed, accuracy, and responsible outreach.
Frequently Asked Questions
Which customers should expansion monitoring cover?
Run expansion research across the full customer base, not only new-logo prospects or accounts near renewal. New facilities, locations, acquisitions, hiring surges, and permits may change a customer’s need for your service before the account manager hears about it. Link those events to the customer hierarchy and current contract scope.
What account baseline is required?
Maintain a baseline of each customer’s legal entities, parent company, operating locations, services bought, stakeholders, and account owner. Match new records to that baseline so a subsidiary opening is visible without creating a duplicate new-business account or contacting another owner’s customer.
Which sources reveal expansion?
Monitor public permits, facility announcements, ownership releases, relevant hiring, and permitted CRM history. A permit can indicate proposed work rather than an operating facility; confirm status, completion evidence, location, and buying responsibility before inferring additional demand.
Does a permit prove a new customer need?
Translate the event into a whitespace hypothesis: which current service could extend to the new site, business unit, or acquired company? Compare the need with the contract’s geographic and service scope. Record both the verified change and the assumption that still needs customer confirmation.
How should account managers act on a signal?
Give the account manager an evidence brief, current relationship context, potential decision owner, and a next conversation. Route uncertain matches to research and coordinate with service delivery before committing capacity. A signal should help a customer conversation rather than trigger an automatic upsell.
How should an expansion program be measured?
Measure monitored-customer coverage, rep acceptance, expansion meetings, sales-accepted expansion opportunities, and attributable pipeline. Review missed changes and duplicate outreach. Expansion is a repeatable monitoring process using the same evidence discipline as new-business research.
